Christian Flores and Paul Carter argue that prefabricated wall panels are becoming more relevant as labour shortages, tighter energy codes and mass-timber construction increase the value of rapid, controlled enclosure.
Pressure is changing walls
Off-site construction becomes attractive when several pressures coincide. Canadian markets face labour constraints, housing demand and productivity challenges at the same time that energy codes demand better thermal performance. Conventional window-wall and curtain-wall systems remain useful, but large-format opaque wall panels can deliver higher levels of insulation and airtightness with a greater proportion of the work completed under factory conditions.
Prefabrication moves risk upstream
A mega-panel is not automatically higher quality because it is built indoors. The interfaces between panels, windows, membranes and structure still determine performance, and those interfaces have to be resolved before production starts. Shop drawings, tolerances, anchors and lifting points therefore need earlier coordination than on a conventional stick-built wall.
Installation is design
Large panels require transport, cranage, temporary restraint and carefully planned erection. Panel size is therefore constrained by more than facade module; road limits, crane capacity and site access all feed back into design. The optimal unit is the one that maximises useful factory work without creating excessive handling risk.
Field joints still matter
Panelisation moves a large portion of air-barrier, insulation and window work into a controlled environment, but it also creates a smaller number of highly consequential site connections. Those joints have to accommodate structural tolerance, panel movement and erection sequence while continuing the water, air and thermal control layers. A factory-perfect panel can still produce a leaky building if the splice between units is inaccessible, overly complicated or dependent on several trades arriving in exactly the right order. This makes design for manufacture and assembly an enclosure discipline. Panel size is influenced by transport, crane capacity and the ability to store and rotate units safely; anchors need adjustment to accept real structural tolerances; and membrane laps must remain reachable after the panel is hung. The aim is not the largest possible panel, but the unit that captures meaningful factory quality without transferring disproportionate risk to installation.
Decisions happen earlier

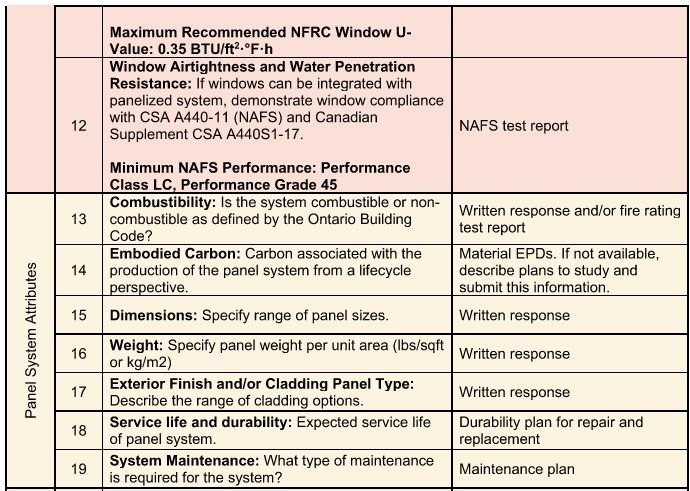

Traditional site construction can absorb late changes through field labour, even when that flexibility is inefficient. Prefabrication removes much of that buffer. Openings, embedded plates, window sizes and interfaces need to be coordinated earlier because production quickly multiplies any unresolved detail. The project team therefore has to bring fabricators and enclosure consultants into design before the architectural package is treated as complete. That earlier commitment is also the route to better QA. Repeated factory inspection can verify membrane continuity, insulation fit and window integration across many units, while representative mock-ups establish the standard for site joints. The presenters' larger point is that off-site construction should not be sold as faster installation alone. Its real value is the opportunity to relocate quality control upstream, provided procurement and design responsibility move upstream with it.
