Eric Chen Lei's account of building with photovoltaic glass is largely an account of a collision. A module is certified as a fixed size making a fixed output, a façade panel is neither, and wind loads and shading coefficients meet electrical standards and an interlayer that burns.

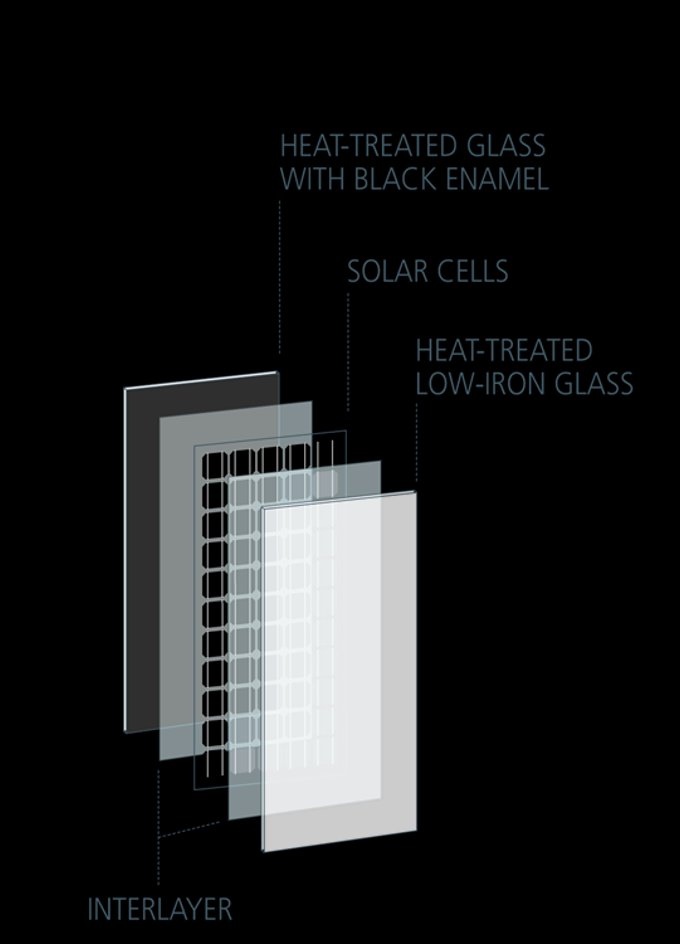

In construction terms the product is unremarkable: two sheets of glass with photovoltaic cells laminated into the interlayer, which can then be built into an insulating unit and coated like any other façade glass. What makes it awkward is everything that follows from the word façade.

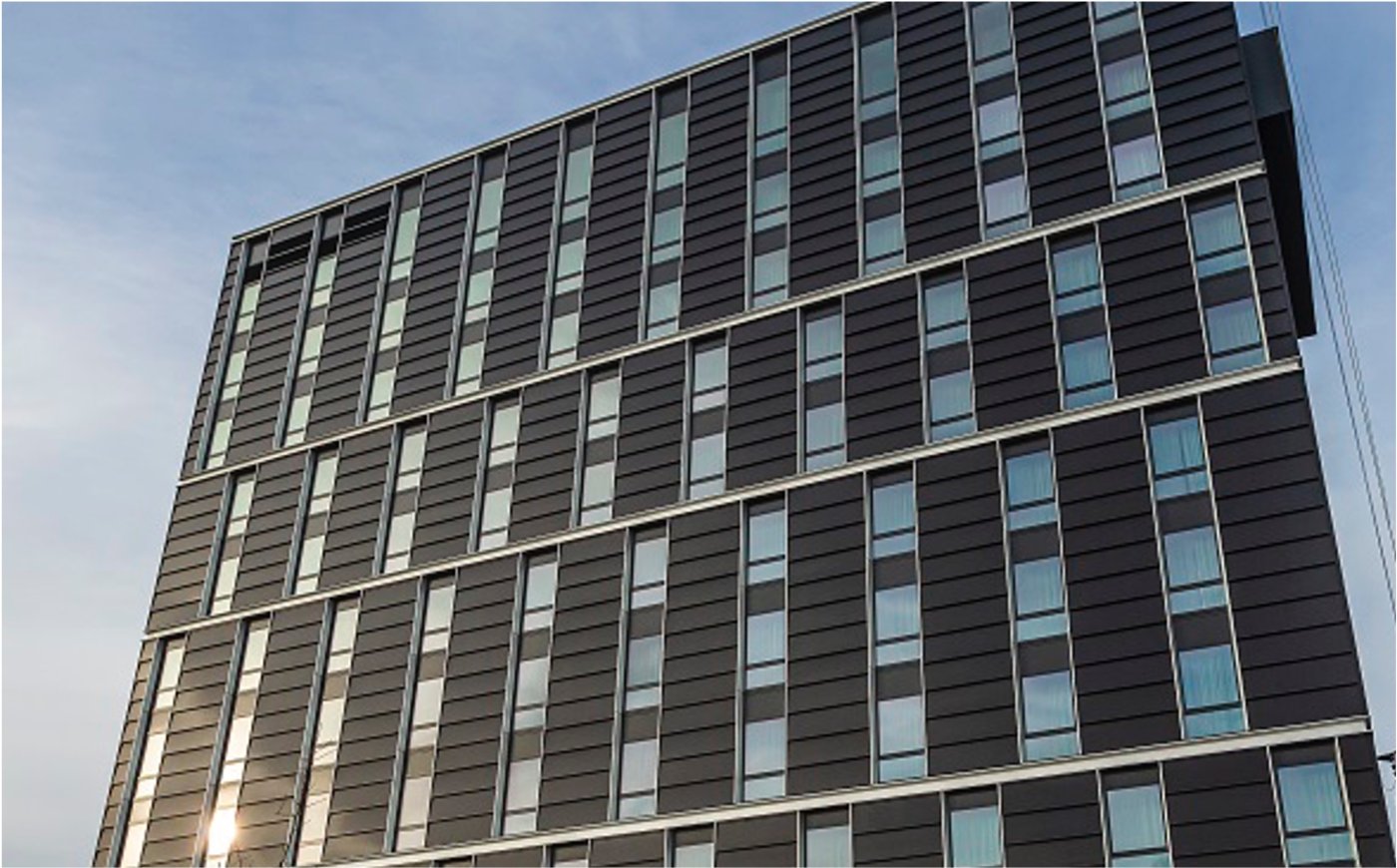

The return is more than the electricity. The cells shade, improving the optical numbers rather than fighting them; the panel counts towards green certification; and maintenance is much like ordinary float glass. In several markets the decisive argument is regulatory: where a new building in a city centre must supply a set share of its energy on site, a tall one has very little roof with which to comply, so the wall is the only place left.
Two certifications that were not written for each other

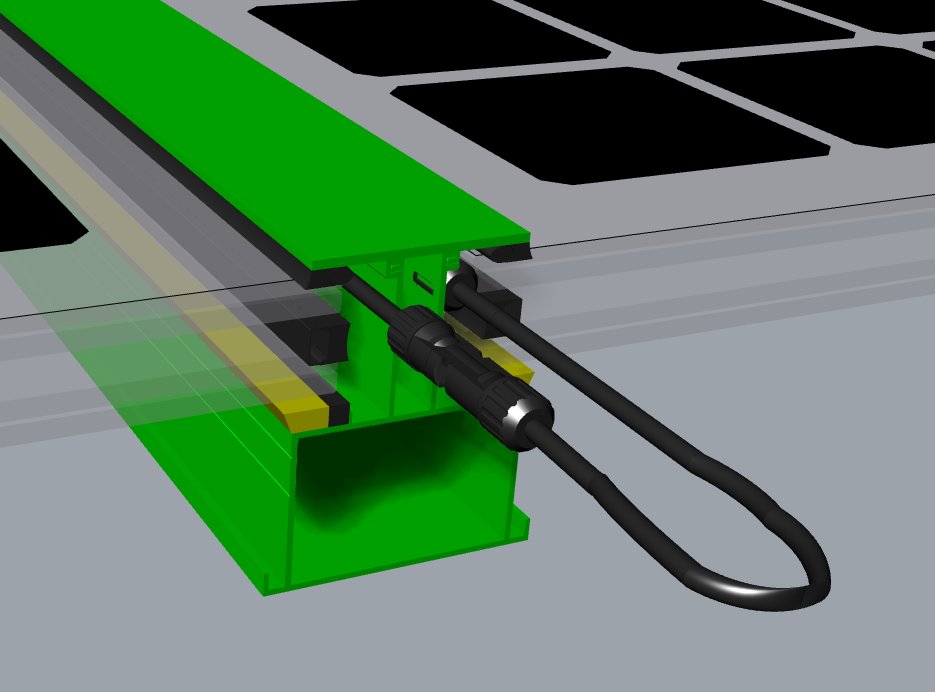

Delivery is a three party affair, and Chen Lei is precise about the order: the façade partner runs the cabling inside the frame as part of the façade design, the panels go in, and the electrical partner then takes the cable to the inverter and ties the system to the grid. Their own work splits in two. At concept they assess position and orientation, glare risk, cell layout, optical data, power estimate, frame integration and maintenance access, and assemble the test reports the authority will want. In delivery they coordinate the two designs, monitor programme and quality, and put an engineer on site for the first panel.
The interlayer burns
Fire has been the live question in Hong Kong since the EN 13501 requirements were updated, and he splits it into material and system. Singapore's civil defence rules sort photovoltaics into wall, roof mounted and integrated, test the panel, check for electrical hot spots and fire test the cable and junction box; the practical difficulty is getting one report to cover several product types. Korea sets national material requirements and increasingly asks for a two or three storey full scale mock-up including the supporting frame and the spandrel behind it, so the laboratory watches the assembly rather than the panel alone.
His conclusion is unusually plain for a supplier. BIPV cannot be described as fully non-combustible, because the interlayer, whether PVB or EVA, will burn. The answer therefore sits at system level: sprinklers near the BIPV zone, fire board or a fire wall behind the panels, and keeping fire escape openings clear of the BIPV altogether. On one project the escape panels were moved off the north elevation to the east and west so the two systems never met.
